MARINA DEL REY
DEVELOPMENT
DEVELOPMENT PROJECTS

UNDER CONSTRUCTION | UPCOMING PROJECTS | COMPLETED PROJECTS | LONG-TERM PROJECTS | COASTAL IMPROVEMENT FUND
PROJECTS UNDER CONSTRUCTION
Click on a project name for more information.
Lot 4 is closed for construction as of December 1, 2025. For alternate lots, visit this map of LA County parking lots in Marina del Rey.
Description
As Marina del Rey’s popular events and recreational opportunities bring thousands of visitors to the Marina each year, there is an increased demand for accessible parking options. The Department of Beaches and Harbors is planning a new public parking structure at Lot 4 to help address this need and enhance the overall visitor experience.
The new parking structure will be built on a portion of Lot 4, located near the Marina del Rey Visitor Center at Admiralty Way and Mindanao Way. The three-level facility and surface lot will provide 368 parking spaces and operate 24 hours a day to better serve the Marina’s year-round activity.
The structure will feature a pay-and-display system with on-site pay stations for convenience. The design will incorporate accessible parking stalls in compliance with ADA requirements, electric vehicle charging stations, and a prominent civic art piece designed by the artist team FreelandBuck. The artwork will resemble abstracted sails placed along the façade of the parking structure facing Mindanao Way.
This investment supports the County’s broader vision for a more accessible, inclusive, and climate-ready Marina del Rey.
Timeline
The timeline below outlines key project milestones. Dates are subject to change based on permitting and approval processes.
| Phase | Start | Completion |
|---|---|---|
| CEQA MND approval | January 2023 | November 2024 |
| Design Phase | January 2025 | August 2025 |
| Jurisdictional Approvals | April 2025 | August 2025 |
| Coastal Development Permitting | June 2025 | November 2025 |
| Anticipated Construction Phase | December 2025 | December 2026 |
UPCOMING PROJECTS
Select a project name for more information.

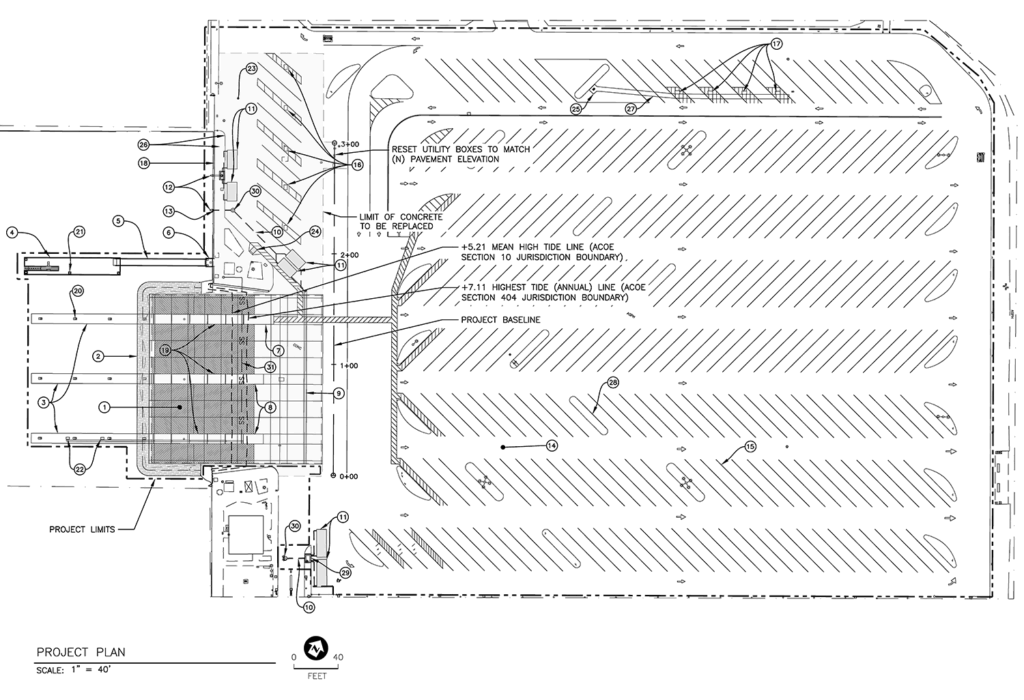

The Los Angeles County Department of Beaches and Harbors is improving the public Boat Launch Ramp Facility located at 13477 Fiji Way in Marina del Rey. These upgrades are designed to enhance safety, accessibility, and the overall user experience while ensuring the facility continues to serve the boating community for years to come.
Construction is anticipated to start at the beginning of Fall 2026 and finish in Summer 2027.
The project includes the replacement of the existing aging dock system and the construction of a new accessible queuing dock adjacent to the launch ramps. The new docks will be built within the existing facility footprint and designed to meet current County marina construction standards and the latest Americans with Disabilities Act accessibility requirements for public marina facilities.
In addition to the dock improvements, the project will enhance the surrounding landside facilities. Planned upgrades include the installation of Low Impact Development stormwater management features to improve water quality, as well as slurry sealing and restriping of the parking lot. These improvements will provide accessible parking spaces and improve circulation throughout the site.
Once completed, the project will deliver a modernized, more accessible, and environmentally responsible facility that better serves residents, visitors, and recreational boaters while supporting continued public access to Marina del Rey’s waterfront.
Site maps

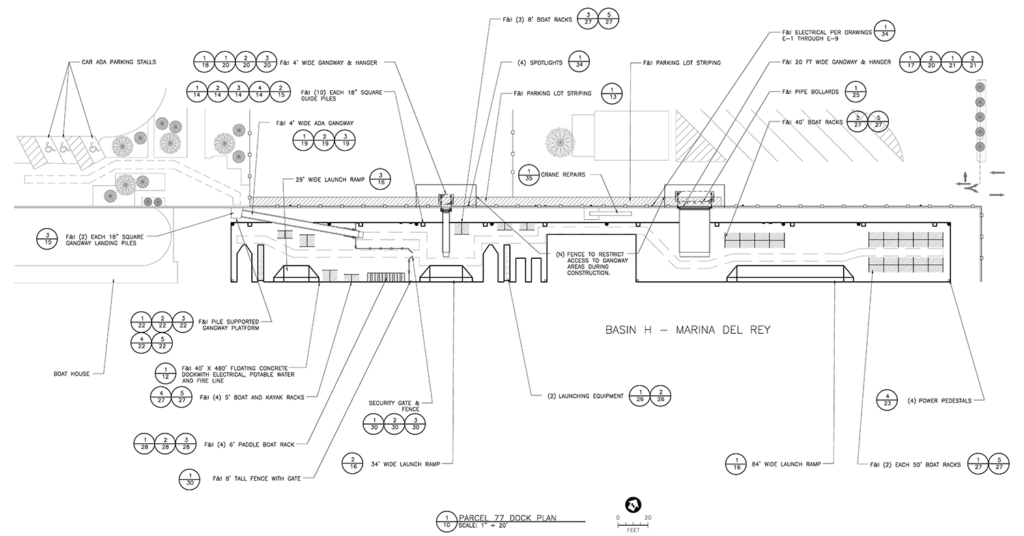

Download Parcel 77 Dock Replacement Project Site Plan
The Los Angeles County Department of Beaches and Harbors is improving the Parcel 77 Dock Facility in Marina del Rey to replace aging infrastructure and provide a safer, more accessible, and more functional waterfront facility for recreational boating.
The project is currently in plan check, with an anticipated construction start date in late 2027.
The project includes removal of the existing dock, piles, and gangways and construction of a new concrete dock system designed to meet current County marina standards and accessibility requirements. The new dock will support a variety of recreational activities, including kayaking, rowing, sailing, and other small vessel uses.
Planned improvements include new launch areas, boat slips, boarding areas, limited storage areas, upgraded utilities, lighting, safety features, and improved access throughout the facility. An ADA-compliant gangway will provide accessible entry from the adjacent parking area, while additional gangways will improve public access and support the movement of larger vessels.
Once complete, the Parcel 77 Dock Replacement Project will deliver a modernized and accessible boating facility that enhances safety, improves operations, and continues to support public recreation in Marina del Rey.
Site map
LONG-TERM PROJECTS
Click on a project name for more information.

Project Scope: The Department of Beaches and Harbors (DBH) will develop a new “Signage and Gateways Master Plan” for Marina del Rey. The purpose of the plan is to update the public gateways, wayfinding, and informational signage throughout Marina del Rey, in order to
- Create an identity and sense of place for the Marina.
- Enhance the experience of Marina del Rey visitors by making the community more easily navigable.
- Create awareness of and highlight water-oriented activities and community features.
Learn more: Marina del Rey Signage and Gateways Master Plan

Project Scope: The Department of Beaches and Harbors (DBH) submitted conceptional design considerations for site improvements at Burton W. Chace Park.
COMPLETED PROJECTS
| Marina “Mother’s” Beach Restroom & Boat Storage Renovation (Parcel 19) |
Project Scope: Renovation and expansion of the existing restroom and office building, with upgrades to the dry boat storage area to increase storage capacity and improve accessibility. Project Completion: July 2026 |
| Aubrey E. Austin Jr. Park Improvement Project (Parcel BR) |
Project Scope: Reconfigure and improve existing park amenities. Project Completion: August 2025 |
| Marriott Hotel (Parcel 9U) |
Project Scope: Six-story Residence Inn and five-story Courtyard Marriott with 288 guest rooms, waterfront restaurant, and amenities. Project Completion: August 2021 |
| Boardwalk Marina del Rey / Pier 44 (Parcel 44) |
Project Scope: Eight new buildings, up to three stories, 82,652 square feet of visitor-serving commercial space, 141 boat slips, and 57 dry boat storage spaces. Project Completion: December 2020 |
| Venice Dual Force Main (Via Marina) |
Project Scope: City of Los Angeles project to install a 54-inch diameter force main sewer line. Project Completion: December 2020 |
| Neptune Marina Apartments (Parcels 10/14) |
Project Scope: Four four-story buildings with 526 residential units and 161 boat slips. Project Completion: June 2020 |
COASTAL IMPROVEMENT FUND
The Coastal Improvement Fund (CIF) was established with the certification of the 1996 amendment to the Marina del Rey Local Coastal Program to finance construction of local park facilities and non-motorized public boating facilities in the Marina del Rey area. Information related to the fund balance and the current CIF fee adjusted to the Consumer Price Index (CPI) is available from the Department of Regional Planning’s webpage.
